Project Stargate - Abilene Data Center

By Ryan Mitchell

Crusoe / Lancium · Abilene, Taylor County

8 buildings · approximately 4M SF · 1.2 GW plannedFirst phase operational · later-phase deliveryUpdates Every Monday
Aerial view of the Abilene campus under construction1 / 5

Aerial view of the Abilene campus under construction. Image; capture date not provided.

The eight-building Stargate core, its construction team and power delivery, plus separately identified filings and the adjacent Microsoft expansion. This Project Insight remains free.

Project overview

Project Stargate in Abilene is the flagship campus associated with the $500 billion U.S. infrastructure initiative announced in January 2025. That figure describes the national investment ambition over four years, not the cost of this one site. The Abilene core comprises eight buildings, approximately 4 million square feet and 1.2 GW of planned capacity at Lancium’s Clean Campus.

The site was already a power and data-center development before the Stargate announcement. Lancium established the location and electrical infrastructure; Crusoe began data-center construction in June 2024. The first phase went live on Oracle Cloud Infrastructure in September 2025 for OpenAI workloads. Later buildings, power delivery and commissioning form a separate sequence of milestones. The first phase is operational, while later buildings continue through fit-out and commissioning.

A November 9 registration adds Eagle 5, a $160 million central administration building at 5441 Spinks Road, to the records for development on the south side of the existing site. Its owner is Abilene DC 9, LLC, the entity also named on the separate Building 9 filing. The administration building’s specific customer and relationship to the original Stargate core or adjacent Microsoft campus are not stated in the registration.

Project at a glance

Master developer / land and power
Lancium
Data-center developer
Crusoe
Cloud operator / infrastructure
Oracle Cloud Infrastructure
Workload customer
OpenAI
General contractor / construction manager
DPR Construction
Electrical
Rosendin
Mechanical / plumbing
Southland Industries
Architecture / master planning
HKS
Technology / design engineering
AlfaTech
Structural engineering
GPLA
Civil engineering
Kimley-Horn
Power-delivery EPC
Mortenson
On-site generation contractor
Primoris Energy Services
Financing partners
Crusoe; Blue Owl Capital; Primary Digital Infrastructure
Investment structure
$15B joint venture; separate construction and equipment budgets
Location
615 FM 2404 · Lancium Clean Campus · Abilene, Taylor County
Core campus
8 buildings · approximately 4M SF
Typical building
Approximately 480,000–485,000 SF
Total size
Approximately 4 million SF
Planned core capacity
1.2 GW
Construction began
June 2024
First phase live
September 2025
Original core delivery target
Mid-2026
Remaining delivery
Fit-out and commissioning; final full-capacity date not confirmed
Grid infrastructure
200 MW / 138 kV plus 1 GW / 345 kV
On-site generation
Approximately 350 MW
Cooling
Closed-loop, non-evaporative liquid cooling
Separate adjacent development
900 MW Microsoft campus · first energization target mid-2027
Eagle 5 / Building 11 CAB
$160M estimate · 95,679 SF · single-story central administration building
Eagle 5 location
5441 Spinks Road, Abilene · south side of existing developed site
Eagle 5 owner / architect
Abilene DC 9, LLC / HKS; no general contractor identified in this filing
Eagle 5 filed schedule
January 15, 2027–February 27, 2028 · registered November 9, 2026
Related Building 9 filing
TABS2026008297 · 617 FM 2404 · $6.3B estimated scope · 738,382 SF
Adjacent Microsoft campus
900MW site; two buildings designed for 336MW critical IT each; first building targeted for mid-2027 energization

Latest updates

Construction timeline, from announcement through delivery. Filed dates and future targets are labeled separately from confirmed events. Reviewed November 16, 2026.

  1. 2021

    Lancium selects Abilene/Taylor County for Clean Campus

  2. May 2022

    Mortenson begins original 200 MW / 138 kV substation

  3. Nov. 3, 2022

    Lancium Clean Campus groundbreaking

  4. 2024

    Existing 138 kV infrastructure expanded

  5. March 2024

    DPR/design/construction team begins intensive collaborative design

  6. June 2024

    Crusoe begins data-center construction

  7. July 18, 2024

    Crusoe/Lancium announce 200 MW initial AI data center and 1.2 GW expansion plan

  8. July 22, 2024

    TDLR files Building 1

  9. Sept. 3, 2024

    TDLR Building 2 filing

  10. Jan. 21, 2025

    Stargate publicly announced

  11. Feb.–Apr. 2025

    TDLR filings for Buildings 3–8

  12. March 2025

    Construction begins on six-building second phase

  13. May 21, 2025

    $15B financing/JV structure announced for six additional buildings

  14. June 2025

    Oracle begins delivering NVIDIA GB200 racks

  15. June 25, 2025

    Buildings 1–2 begin connecting to Abilene Northwest substation, according to grid analysis

  16. Sept. 30, 2025

    Crusoe announces first phase live

  17. Nov. 2025

    Building 8 topped out

  18. Dec. 19, 2025

    First transformer at new 1 GW/345 kV substation energized

  19. Jan. 10, 2026

    345 kV connection to Mulberry substation energized, according to grid analysis

  20. March 10, 2026

    New 1 GW substation fully energized using temporary transformers

  21. March 2026

    OpenAI drops additional Abilene expansion; Microsoft subsequently takes adjacent 900 MW project

  22. April 2026

    Oracle says 200 MW operational

  23. June 2026

    Yes Energy reports ~407 MW facility load

  24. July 2026

    Independent satellite-based estimate puts Buildings 3–4 into operation

  25. Sept. 2026

    Buildings 5–8 structurally complete/roofed but public operational confirmation remains limited

  26. December 17, 2025

    Separate filed scope

    Building 9 registration

    Abilene DC9, LLC registers a $6.3 billion, 738,382-square-foot single-story building at 617 FM 2404, described as the ninth data center on the south side. The filed February 21, 2026–April 15, 2027 window is not proof of the exact field start or operating date.

  27. November 9, 2026

    Registered

    Eagle 5 administration building filed

    TABS2027005518 records a $160 million, 95,679-square-foot central administration building, with HKS as design firm and January 2027–February 2028 filed construction dates. Customer assignment and the building-specific contractor remain unconfirmed.

Project Team

DPR Construction logo
Rosendin logo
Southland Industries logo

Company logos.

Design: KH, HKS, GPLA, BW Design Group, MPS, Cupertino Electric, Maverick and Sabre.

Multi-prime: DPR Construction, Rosendin and Southland Industries.

Trades/prefab: Wagner, WW Afco, Digital Building Components, EIG, JLA, E2 Optics, Walker Electric, Western States, Vanguard, Flynn, North Texas Fire Protection, Cherry Coatings, Goins Crane Services, Instor/Accelevation and Crusoe Industries.

The announced design calls for each building to support up to 50,000 NVIDIA GB200 NVL72s connected through one integrated network, providing computing infrastructure for AI training and inference.

At the time of the expansion announcement, approximately 2,000 people were working on site each day. The additional buildings were expected to increase that workforce to nearly 5,000.

The Development Corporation of Abilene estimated that the initial phase could generate approximately $1 billion in direct and indirect economic impact over 20 years. The expansion could increase that contribution substantially, although this estimate applies to the initial phase rather than the completed eight-building campus.

Oracle subsequently reported nearly 20 million worker hours and up to 9,000 workers on site to date by June 2026. This later cumulative account covers a broader period than the earlier ENR snapshot; it should not be read as 9,000 workers present simultaneously.

DPR’s LinkedIn announcement marking Building 8’s topping out cited 17 months and more than 10 million labour hours. This is a separate milestone from Oracle’s later workforce update.

Design

A repeatable building design is a major reason the project could move so quickly. DPR describes each building as roughly:

  • 4 data halls
  • Approximately 106,000 sq ft per data hall
  • A central utility hall
  • 500 racks per hall
  • Up to 25 MW of IT load per hall
  • Approximately 100 MW of IT capacity per building

The architecture follows a repeatable model, with standardized components and the same core design repeated across eight buildings.

That repetition matters because conventional hyperscale construction often involves substantial bespoke design and coordination between buildings. Reusing the design allows the team to carry lessons and construction processes from one building to the next.

Power

Abilene’s power strategy combines access to regional wind and renewable generation, expanded grid infrastructure and behind-the-meter natural-gas generation. Each element supports a different part of the campus’s phased delivery and operating requirements.

Original grid connection

The campus initially relied on a 200 MW, 138 kV substation, providing the electrical infrastructure needed to advance the first two buildings. This existing connection gave the development a starting point while the larger power-delivery system was built.

Expansion substation and energization

Mortenson then constructed a 1 GW, 345 kV greenfield substation on approximately 12.5 acres. Construction began in the second quarter of 2025. The first transformer was energized on December 19, 2025, followed by all five main transformers on March 10, 2026.

Three of the five transformers were temporary units, allowing energization to proceed while permanent equipment was being procured. This approach helped bridge long equipment lead times. Substation energization establishes power-delivery capability; it does not by itself mean every data hall is commissioned or operating at full load.

Transmission connections

Yes Energy’s analysis identifies a double 345 kV transmission corridor associated with the campus and the Abilene Mulberry Creek substation, alongside the existing Abilene Northwest 138 kV infrastructure. Together, these connections support the transition from the initial development phase to the larger campus.

On-site natural-gas generation

Crusoe initially described the on-site gas plant as backup and bridge power. Primoris’ documentation lists ten turbines: five Solar Titan 350 units and five GE LM2500XPRESS units, with total generation capability exceeding 350 MW.

Crusoe says the turbines use selective catalytic reduction (SCR) for emissions control and are intended to replace conventional diesel backup generation. In a McKinsey interview, Crusoe CEO Chase Lochmiller explained that renewable output is not always available when needed and that waiting for all required grid infrastructure would take substantially longer.

The resulting system combines renewable power available through the grid with on-site dispatchable generation. The gas plant supports reliability and the delivery sequence while the campus’s electrical infrastructure develops.

Power architecture: wind and renewables + grid connections + behind-the-meter natural-gas generation.

Water

The campus uses a recirculating facility-water system with heat rejected through air-cooled equipment, avoiding routine evaporative cooling-tower consumption. The design supports direct-to-chip cooling, rear-door heat exchangers and air cooling so that hardware configurations can change without requiring one fixed cooling approach. Closed-loop cooling still needs an initial fill and maintenance top-ups; it does not mean that the campus uses no water.

Saving water before the first server switches on

Southland designed a high-flow reverse-osmosis flushing system for the chilled-water pipes, with the team projecting a 75% reduction in flushing-water use. The innovation brings water conservation into construction itself: preparing the cooling pipework, not just running it once the data halls are operational.

The 75% figure applies to projected water savings during pipe flushing, rather than total campus water consumption.

Buildings 3–8: Construction Budgets Are Not Campus Investment

The later buildings repeat approximately 480,000–485,000-square-foot shells, with the supplied registrations generally showing $292 million per shell and approximately $384 million per tenant-improvement package. A $292 million shell estimate should not be presented as the complete cost of an equipped building. Package boundaries, scope changes and equipment procurement must be reconciled before aggregating estimates. The $15 billion joint-venture financing structure operates at a different level from these individual registrations.

What happened to the planned expansion?

The original core plan grew from two buildings to eight buildings, with 1.2 GW of planned capacity. A further expansion was then contemplated beyond that core campus.

In March 2026, OpenAI decided not to proceed with the additional Abilene capacity and instead allocated additional capacity elsewhere. Reporting around that decision created confusion about whether Stargate Abilene itself had been canceled.

The existing eight-building, 1.2 GW campus continued. The change concerned the additional capacity beyond it.

Microsoft took the adjacent expansion.

On March 27, 2026, Crusoe announced a 900 MW AI factory campus for Microsoft immediately adjacent to the existing Abilene infrastructure. The separate development consists of:

  • Two additional buildings
  • Closed-loop liquid cooling
  • A dedicated on-site power plant
  • First building targeted for energization in mid-2027

Industry Recognition

The project was announced as the North American Data Center Project of the Year at the 2025 DCD Global Awards. Its significance for construction readers is the combination of repeated design, prefabrication, high-density cooling and coordinated infrastructure delivery. The execution model is useful to study, while the operating status of each building still needs to be tracked separately.

Why Abilene?

The choice of Abilene brings together power availability, existing infrastructure, land and local support.

1. Wind power availability

Abilene sits in a part of West Texas with substantial wind generation. The opportunity extends beyond the amount of wind power available.

Crusoe CEO Chase Lochmiller described renewable generation being curtailed when output exceeded local transmission or demand capacity, including periods of negatively priced electricity. A large, flexible electricity consumer can absorb some of that otherwise-constrained generation.

That relationship between generation, transmission and demand helps explain the location more precisely than electricity prices alone.

2. Existing transmission infrastructure

Lancium had already begun building electrical infrastructure before the data-center development. Mortenson says work on the original 200 MW, 138 kV substation began in May 2022, followed by transmission and interconnection work. The infrastructure was expanded in 2024.

That head start helped the site move quickly. The development could build on an established power campus rather than begin the land and interconnection process from scratch.

Starting from scratch: find land → request a 1 GW interconnection → wait for grid upgrades → build.
Abilene’s starting point: existing power campus → existing land → existing interconnection → build AI infrastructure.

3. Available land

The Clean Campus provided a large, contiguous development footprint suitable for multiple buildings approaching 500,000 square feet each, alongside substantial electrical infrastructure.

4. Workforce

Abilene’s economic-development organizations emphasized access to universities, technical training and a regional workforce. Crusoe also cites workforce availability as a reason for selecting the location.

5. Local government support

The City of Abilene and Taylor County supported Lancium’s development, with tax-abatement arrangements forming another part of the site-selection story.

In August 2025, the City approved separate agreements for Buildings 1–8 providing an 85% abatement on the taxable value of new improvements and tangible personal property for 10 years. A second 10-year abatement structure is also available under the agreements.

6. The downside: water

Abilene’s relatively dry West Texas location and historical water-supply constraints make conventional evaporative cooling a less obvious fit. That context helps explain the importance of the campus’s closed-loop, non-evaporative cooling architecture.

Eagle 5 and Building 9: related filings, distinct packages

Eagle 5 is the project name, while the facility field says Abilene Building 11 CAB. It is an administration facility, not an additional 95,679-square-foot data hall. The matching owner entity and south-side descriptions connect it to Building 9’s development records; neither record identifies the administration building’s eventual customer.

The $160 million administration estimate and $6.3 billion Building 9 estimate measure their registered scopes. They should not be added to the existing $15 billion financing structure as if all three were independently additive construction contracts. No detailed cost breakdown or administration-building megawatt load is supplied.

Crusoe separately announced its adjacent Microsoft campus on March 27, 2026: two buildings of 336MW critical IT each, supported by 900MW behind-the-meter generation and battery storage. The company projected approximately 2.1GW across the existing and adjacent developments and targeted first-building energization in mid-2027. Those figures describe the combined development plan, not a revised 2.1GW capacity for the original eight-building Stargate core.

The established DPR, Rosendin and Southland roles at the core campus are not assumed to be awards for Eagle 5. HKS is specifically named in the new administration-building registration; additional package appointments need their own evidence.

What to watch next

  • Eagle 5’s customer assignment, building-specific contractor and confirmed construction start
  • Reconciliation of Building 9 and administration-building delivery with the adjacent Microsoft program
Read the Eagle 5 administration-building update ↗

Campus Construction Gallery

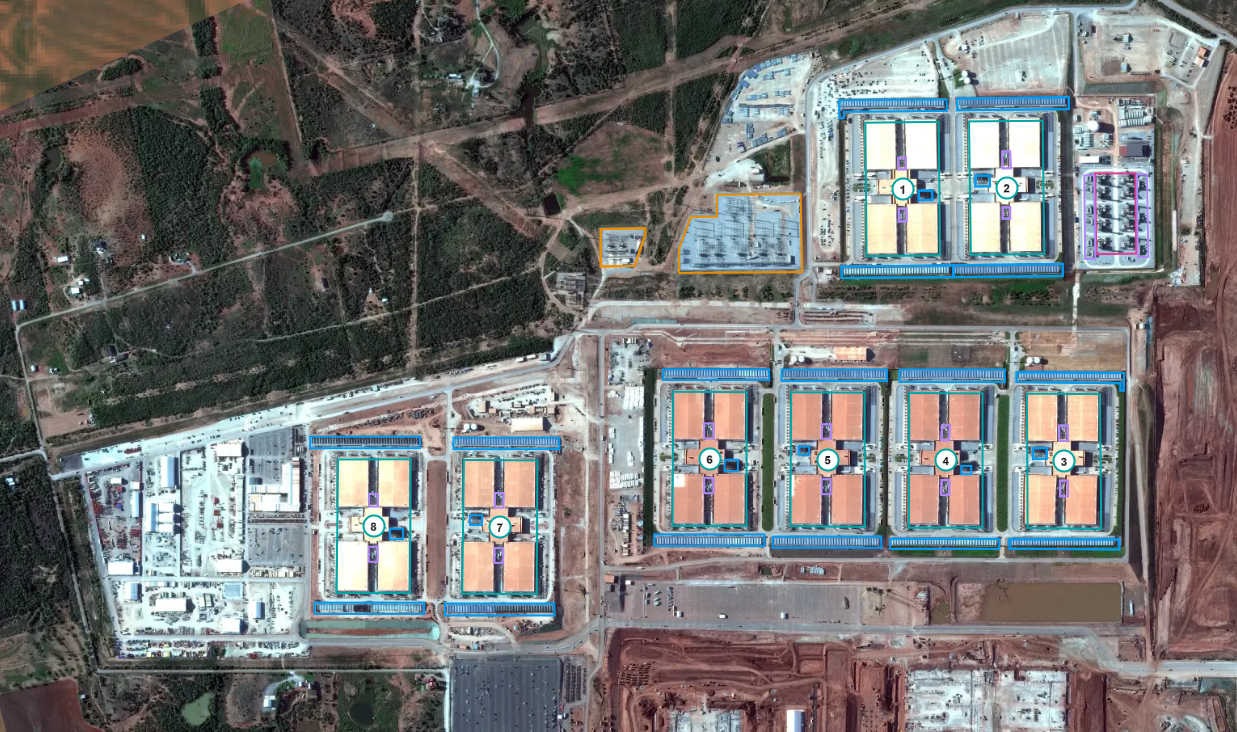

Annotated eight-building campus layout
