Red Creek Data-Center Proposals Put 2.2GW of Demand in Focus

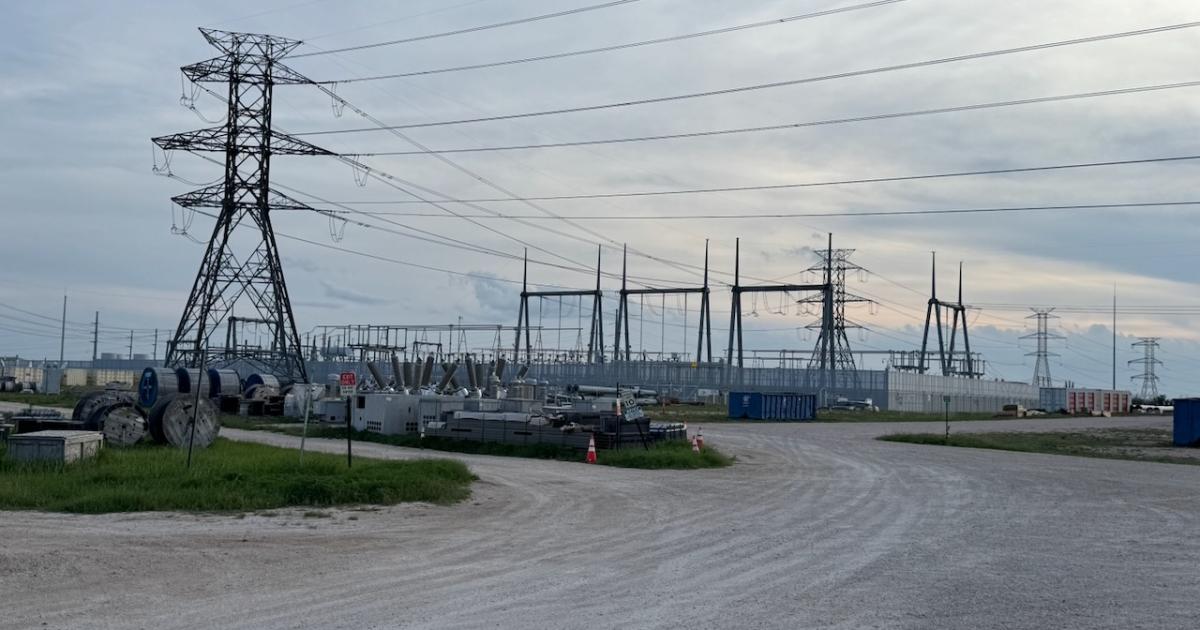

Transmission lines and electrical equipment at the Red Creek power substation
Red Creek substation photo: San Angelo LIVE!

Cipher and Emergent are pursuing separate developments around the Red Creek substation, with utility review and tenant commitments still shaping the construction outlook.

Two proposed data-center developments are concentrating attention on AEP’s Red Creek electrical infrastructure. A September 22 county presentation, reported the following day, outlined a 1GW Cipher proposal and a separate 1.2GW Emergent proposal.

Together, the stated loads amount to 2.2GW. They represent proposed demand, not energized capacity or a confirmed construction award.

Project at a Glance

Location:
Red Creek substation area, Tom Green County
Investment:
Total development budgets not confirmed
Electrical interface:
345kV substation
Schedule:
A potential first-quarter 2027 start remains conditional
Delivery team:
Cipher and Emergent identified as developers; construction contractors not confirmed

Power Comes Before the Buildings

The presentation described utility and state review as remaining conditions. Tenant agreements were not yet signed, and final building footprints depended on those commitments. The schedule discussed a 14–20-month construction period, beginning with substation work if the required reviews clear.

A road-use agreement also remained part of the delivery discussion. There is no verified building-area total or complete contractor roster in the reviewed material.

Where Contractors Could Fit

Based on the proposed use and electrical interface, likely work areas include site preparation, access roads, drainage, high-voltage infrastructure, underground electrical systems and eventual building services. This is an assessment of potential scope, not evidence that those packages have been released.

Electrical suppliers should distinguish utility-side work from developer-owned installations. Civil contractors should establish the approved haul routes and the party responsible for road restoration before pricing a package.

What Remains Unresolved

Key questions are whether each developer secures its intended load, who signs as the ultimate customer, and which contractor will manage construction. A conditional target date should not be treated as a notice to proceed. Procurement timing, design responsibility and confirmed subcontract opportunities still need direct verification.
